Phased Resort Expansion: Capsule House Modules
Phased resort expansion as a project decision: end-state masterplan, three-trigger phase gates, procurement structure and repeated critical path.
Phasing a resort is a capital structure decision disguised as a construction sequence. Buying all keys at once front-loads spend and risk; phasing lets each stage earn the next, but only if the decisions taken in phase one do not constrain phases two and three. This page is written for the people who carry that decision — owner, finance lead, development manager and operations — and follows the order in which the choices actually arrive. The investment arithmetic sits on our capsule house ROI model.
Who Decides What
| Role | What they need settled | Decision they own |
|---|---|---|
| Owner / developer | End-state key count and masterplan | Go or hold on each phase, and when |
| Finance | Capital per phase, funding source, trigger to proceed | Phase gate criteria |
| Development manager | Infrastructure sized once, installation windows | Sequence and programme |
| Operations | How guests are protected during works | Closure and access plan per phase |
| Supplier / factory | Frozen specification, production slots | Delivery milestones per phase |
The common failure is that finance owns the phase gate but nobody owns the end-state drawing. Phase two then discovers that phase one consumed the serviced area, or was built where phase three's road had to run.
Draw the End State First
Before ordering anything, produce a full masterplan showing every phase, including access roads, services routes, drainage outfalls and utility plant location for the final key count. The masterplan does not commit you to build it; it commits you to reserve it.
- Services capacity. Water, sewerage or treatment, electrical supply and data sized for the end state, even if the first phase uses a fraction.
- Routes and easements. Services corridors reserved so later phases do not require cutting through finished ground.
- Access. The crane stand and haul route for later phases identified before earlier units occupy the obvious positions.
- Plant location. Generator, treatment plant or switchroom sited so later units can connect without relocating anything.
- Guest facilities. Reception, dining and parking sized once, at end-state scale.
The Three-Trigger Rule for Proceeding
Writing the trigger in advance removes the argument later. A workable phase gate has three conditions, all quantified:
- Performance. Occupancy and rate from the operating phase meet or exceed the assumption used to justify the next one.
- Cash. Funding is committed, not merely identified, before the order is placed.
- Readiness. The serviced expansion zone is actually complete and tested, including spare capacity at the plant.
If any one is missing, the correct answer is to wait. Ordering units before services are ready produces storage charges and units standing on the ground earning nothing.
Procurement Structure Across Phases
How you buy across phases matters as much as what you buy. Three mechanisms, with trade-offs:
- Separate orders. Maximum flexibility to change specification; risk of price movement, longer second lead time and no reserved production slot.
- Framework agreement. Agree the specification and pricing basis once, call off units as needed. Protects against price movement and shortens lead times; requires the discipline to freeze the specification early.
- Single order, staged delivery. Locks pricing and slots across the whole programme, but commits you to the end-state quantity earlier and may require storage.
Whichever you choose, write down: what is frozen in the specification, how long quoted pricing is valid, what triggers a price review, how long production slots are held, and what happens to spare-parts standardisation if the configuration changes. Ask these before the first deposit, not at phase two.
Programme: The Same Critical Path, Repeated
Each phase repeats a short chain, and the same two items slip every time:
- Specification frozen and drawings approved — including any change from the previous phase.
- Production slot confirmed against the phase date.
- Shipping and clearance, with documents consistent across the set.
- Site works and foundation — running in parallel with production, not after it.

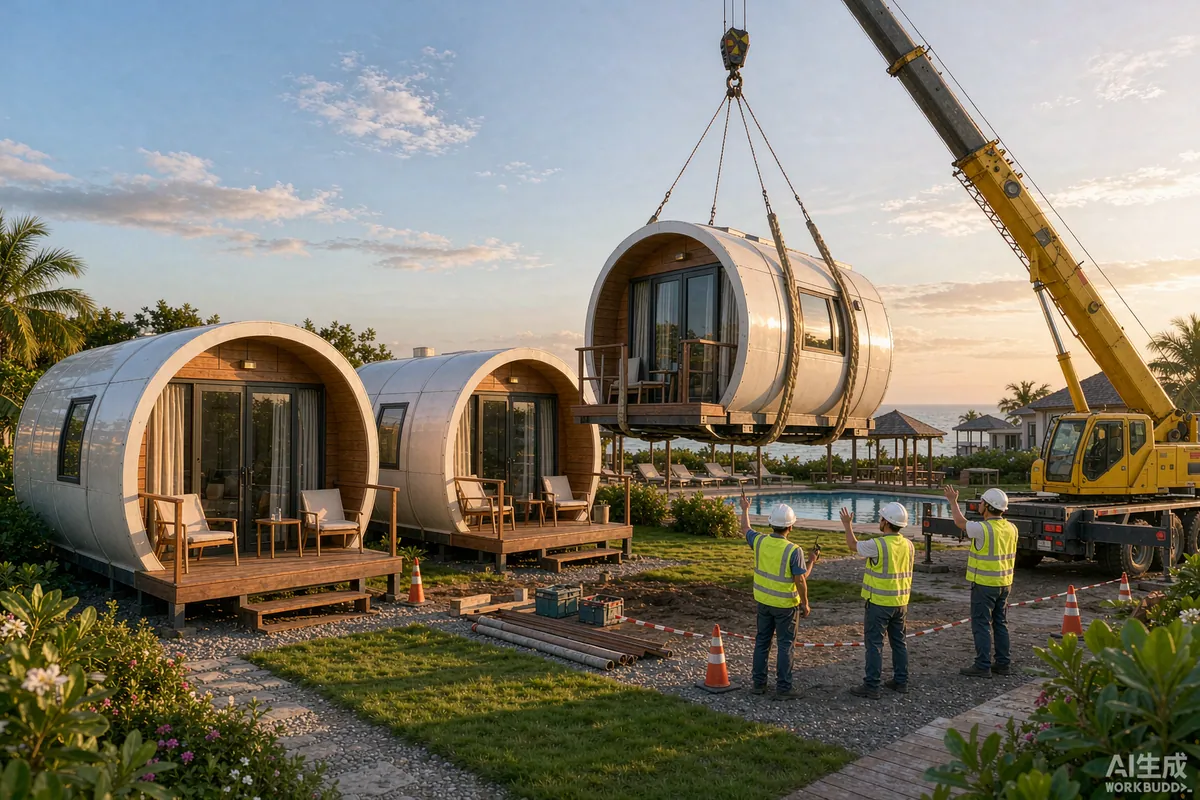

- Cranage and set, with the access route reserved and verified.
- Connection, commissioning and snagging.
- Handover to operations with O&M documentation and spares.
Site works in parallel with production is the most economical programme protection available. It costs nothing extra and it repeatedly saves weeks.
Working Around Operating Guests
From phase two onward, the site is not empty. Plan three separations deliberately:
- Physical. Hoarding or natural separation keeping guests clear of vehicle movements and lifting.
- Temporal. Shoulder-season or low-occupancy windows for the noisiest and most disruptive operations.
- Routes. Separate haul routes from guest routes, including at night, with lighting and signage.
Dust, noise and early-morning deliveries generate complaints that cost more than the programme time they save. Brief the installation contractor on occupancy before mobilisation, and hold operations in the loop weekly.
Acceptance, Repeated Per Phase
| Hold point | Evidence to require |
|---|---|
| Pre-production | Approved drawings; confirmed configuration matches the frozen phase-one specification |
| Pre-shipment | Photographic record; test results available from the factory |
| Arrival | Seal matched to bill of lading; condition photographs before opening |
| After set | Level and anchoring check; connection check |
| Commissioning | Cooling, extraction, lighting, water and protective devices run and tested |
| Handover | Snagging list with close-out dates; documentation delivered; spares count confirmed |
Unit Mix Across Phases
Phasing is also a market-research instrument, and the most economical lesson you will ever buy is the occupancy data from phase one. Read it before fixing phase two: which unit type booked earliest, which had the highest cancellation rate, what guests asked for that you did not provide, and which configuration produced the best rate rather than merely the most enquiries.
Then adjust the mix rather than simply repeating it. Because services were sized for the end state, changing the mix usually costs less than it would in a conventional build — provided the infrastructure allowances were made generously. Keep one thing constant regardless of mix: standardise on the same services interface across all unit types so later phases never require re-plumbing or rewiring.
Mistakes That Repeat Across Phases
- Infrastructure sized for phase one, excavated again for phase two.
- Units placed where the later access road or crane stand had to be.
- Specification quietly changed in phase two, breaking spares and maintenance standardisation.
- Site works started after units arrived rather than during production.
- Operations not consulted, so installation collides with peak occupancy.
- Each phase treated as a separate procurement, losing pricing and scheduling continuity.
What Haishu Provides
Haishu supplies on a factory-direct basis with units delivered substantially finished, so each phase is connection and commissioning rather than construction. Container-efficient transport keeps subsequent shipments on the same documentation and handling pattern, which shortens each repeat cycle. The Galactic A series — a compact A30, a mid-size A50 and a larger A70 commonly configured over two levels — allows later phases to change the unit mix without changing services strategy, so you can shift from one-bedroom inventory to larger units as the market tells you what sells.
What to Send Us
Send your masterplan or end-state key count, site access conditions, the phasing you are considering, electrical supply characteristics and target opening dates per phase. We will return the production and shipping milestones, the framework pricing basis and what must be sourced locally. We publish no price figures — they depend on configuration, quantity, route, market conditions and date, and only your suppliers can establish them. Review the Galactic A series configurations and send your details through the contact page.
Talk to the Factory
Ready to Ride the 2026 Wave?
Get the latest catalog, pricing tiers and a layout sketch for your land — straight from the engineering team.
